Async-First Meeting Rules for Engineering Teams

· 8 min read
Artur Pan
CTO & Co-Founder at PanDev

Engineers lose an average of 11.5 hours per week to meetings and the refocus penalty that follows them. UC Irvine's Gloria Mark (the 23-minute refocus study, updated 2023) now puts the post-interruption cost for knowledge workers at 23 minutes and 15 seconds per context switch. Four meetings a day is literally three hours of lost focus time on top of the meetings themselves. Your Google Calendar tells you 6 hours; the real cost is closer to 9.

This is a playbook for cutting meeting load in half on an engineering team without losing the alignment that the meetings were (theoretically) providing. It's async-first, not async-only — some meetings are still the right tool, and pretending otherwise is how async cultures themselves fail.

{/* truncate */}

The problem: the default meeting is the cheapest meeting to schedule

Booking a 30-minute meeting with 5 engineers costs the booker 2 minutes. It costs the attendees 2.5 hours — half an hour each, plus the refocus tax. This asymmetry is why calendars are full. Nobody accounts for the receiver-side cost.

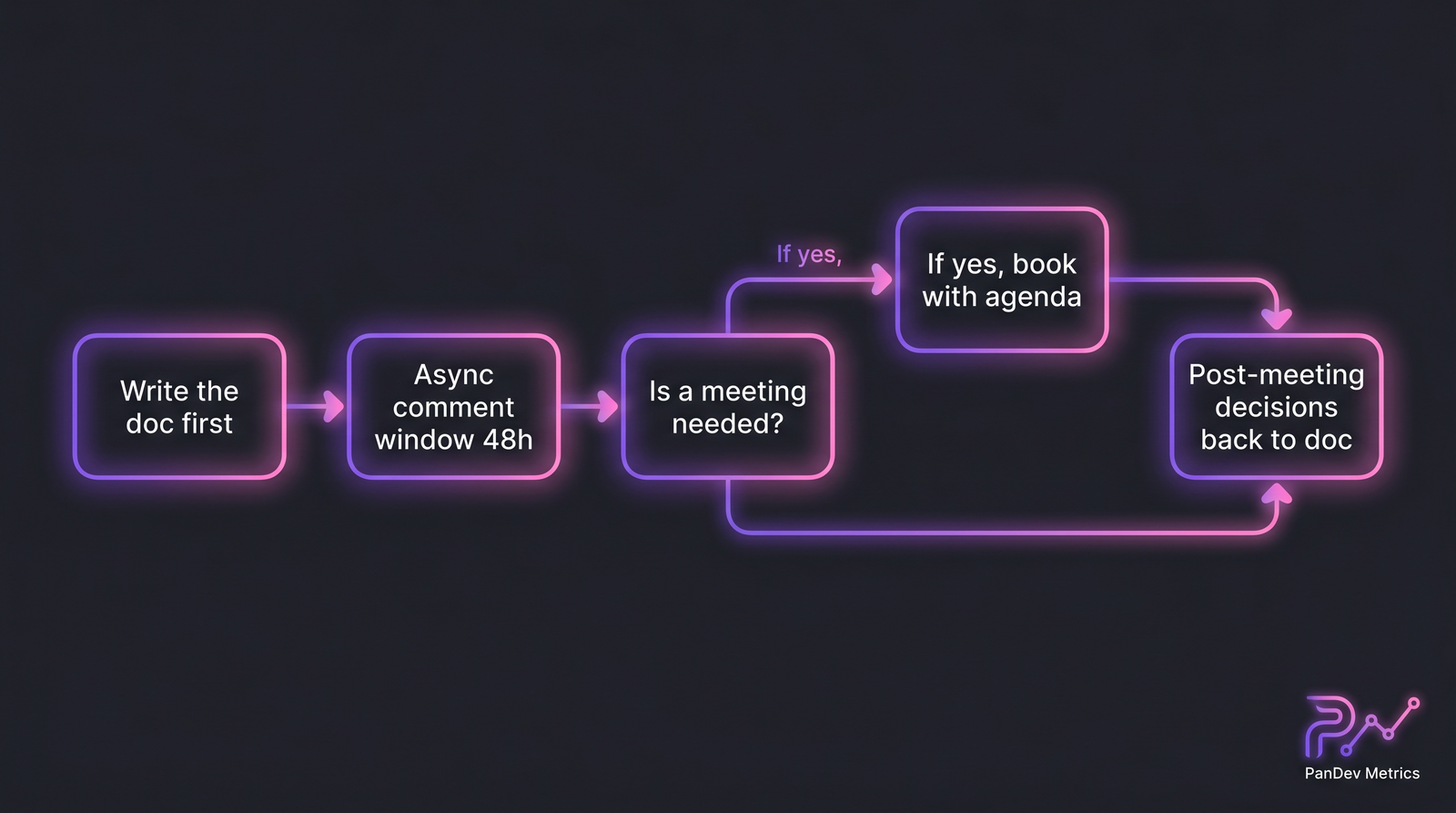

Flow diagram: write the doc first, async comment window 48h, decide if a meeting is needed, if yes book with agenda, post-meeting decisions back to doc The async-first decision loop. Most proposed meetings die at the "is this meeting needed?" question once the 48h async window closes.

Microsoft Research's 2022 Work Trend Index surveyed 30,000 knowledge workers — engineers were in the highest-meeting-load quartile, averaging 19 meetings per week. The DORA 2024 State of DevOps report linked "meeting density" inversely to deployment frequency: teams in the top meeting-load quartile deployed 32% less frequently than teams in the bottom quartile, controlling for team size and stack.

The framework: 7 rules

Rule 1 — Write the doc before you book the meeting

If you can't articulate the discussion topic in a 1-page doc, you're not ready to meet. The doc becomes the pre-read, the agenda, and the note-taking surface all at once.

Amazon's "six-page narrative" practice is the famous version, but a lightweight 1-pager works for most engineering discussions:

# {Topic}

## What decision are we making?
{one paragraph}

## Context
{what led here, what we've tried}

## Options
1. Option A — pro / con
2. Option B — pro / con
3. Option C — pro / con

## My recommendation
{which option, why}

## What I need from you
{comments by Thursday / attend Friday meeting / async approval}

Half the time, writing this reveals the decision can be made without a meeting at all.

Rule 2 — Give 48 hours of async comment time before deciding to meet

Post the doc. Set a 48-hour async window where anyone can comment, ask questions, propose edits. Most team decisions resolve in the comment thread.

The contrarian rule: if the comment thread resolves the decision, cancel the meeting. Don't meet to "formalize" a decision that's already been made. This is the #1 thing teams forget — they schedule the meeting before posting the doc, and then hold it even when async already settled the question.

Rule 3 — Default stand-up to async

Daily stand-ups are the highest-volume meeting category. Most of them should be async updates in Slack or a dedicated tool.

Stand-up formatTime cost per week (6-person team)Information density
15-min daily sync7.5 hours (6 × 15 × 5)Low (verbal, rarely captured)
5-min async Slack thread30 min (6 × 5 × 1 thread)High (searchable)
Weekly 30-min sync + daily async3 hours (6 × 30 × 1)High

A weekly 30-min sync for dynamics (blockers, morale, strategy) plus daily async updates covers what a daily sync did, at 40% of the time cost. We've seen this switch land well in teams from 4 to 40 engineers.

Rule 4 — Default planning to async, review to sync

Planning can be async with a structured doc. Retrospectives benefit from synchronous video — the emotional texture matters, and "async retro" has a bad track record.

Meeting typeDefault modeWhy
Stand-upAsyncStatus updates are readable
Sprint planningAsync + 30-min confirmation syncEstimates are individual work
Backlog groomingAsyncComments on tickets beat talking
RetroSyncEmotional signal, psych safety
1:1SyncRelationship-first
Design reviewDoc + async + optional syncMost resolve in comments
Incident responseSyncLatency matters
All-handsSync (with recording)Shared experience, Q&A

Not everything should be async. Retros, 1:1s, and incident response are sync-first for good reasons. Flattening everything to async is how cultures lose connection.

Rule 5 — Shrink meeting sizes, not meeting lengths

A common mistake: "let's make all meetings 25 minutes instead of 30." This ignores that meeting cost scales with attendees, not minutes. Cutting a 30-minute 8-person meeting to 25 minutes saves 40 person-minutes. Cutting it to 30 minutes with 4 attendees saves 120 person-minutes.

Rule: any meeting with more than 8 attendees defaults to doc + async. In-person only if urgent and unresolved.

Rule 6 — Respect focus-block time zones

Mandatory no-meeting windows. 9:30am-11:30am local and 2pm-4pm local are good defaults — our own focus-time data shows these windows produce the highest-quality coding output when uninterrupted.

Managers should protect these windows harder than engineers do. A meeting booked at 10am "because it was the only time everyone was free" usually means the booker didn't try the 8am or 4pm slots.

Rule 7 — Write down the decision, not the discussion

If a meeting happens, the artifact is the decision, not a transcript. Three sentences:

  • Decision: we will do X
  • Rationale: because of Y
  • Next steps: person A does Z by date D

Post to the doc and to the async channel. Nobody needs the 25-minute discussion recap; they need to know what was decided and what happens next.

Common mistakes

MistakeWhy it hurtsFix
"Recurring meeting" on autopilotCost compounds, no reviewQuarterly audit; kill if no specific decision
Agenda = "sync up"No concrete decision, no outcomeAgenda must be a question or decision
8+ attendees routinelyCost explodesDoc + async for > 8
Meetings during focus blocksDouble-costs productivityProtected 2h blocks, 2x/day
No-doc meetingsAttendees unpreparedDoc posted ≥24h before
Async-only retroFlattens emotional signalKeep retros sync
30-min default slotFills the time available15-min default; book up if needed

The checklist

  • Doc posted ≥ 24h before any meeting with a decision at stake
  • 48h async window before calling a meeting
  • Daily stand-up is async, weekly sync is 30 min
  • No meetings during 9:30-11:30 and 14:00-16:00 local focus blocks
  • Any meeting with >8 attendees justified in writing
  • Decision + rationale + next steps written after every meeting
  • Recurring meetings audited quarterly

How to measure if it's working

Track per engineer, weekly:

  • Meeting hours — target under 7/week for ICs, 15/week for EMs
  • Focus time blocks ≥ 45 min — target ≥ 10 per week
  • Context switches per day — target under 4 (anything over 6 correlates with burnout per our focus-time post)

PanDev Metrics surfaces all three via IDE heartbeat data combined with calendar integration — coding sessions, meeting blocks from calendar, and the focus-time windows between them. Teams switching to async-first see the focus-time distribution shift visibly within 4-6 weeks. The metric to watch is mean focus block length; when it rises from ~18 minutes to ~42 minutes, the new cadence is working.

Honest limit: meeting load is a leading indicator of delivery capacity, not a cause of it. A team that cuts meetings but doesn't change what it's working on won't magically ship faster. Our data can tell you whether you're spending more time coding; it can't tell you whether the coding is on the right thing.

When this framework doesn't fit

  • Very early-stage startups (<10 people) — the coordination cost of async docs exceeds the cost of 10 meetings a week. Stay sync until ~12 people.
  • Fully co-located offices — in-person hallway conversations are effectively sync and free; forcing docs can feel bureaucratic. Adopt selectively.
  • Crisis incident response — obvious, but worth stating. When prod is down, sync Slack + video beats docs.
  • Sales / customer-facing roles — their calendar constraints differ fundamentally; this playbook is for engineers, not the whole company.

Ready to see your team's real metrics?

30-minute personalized demo. We'll show how PanDev Metrics solves your team's specific challenges.

Book a Demo
